There were six Single-Family Home Applications reviewed by ARC in September. One was recommended for approval. The remainder were held for additional information. Seven other applications were reviewed. Four were recommended for approval and three were held for additional information.
Effective September 30, 2025, there were 49 new homes in the approved construction process. Additionally, there are three homes that are currently under construction (authorized by Charlotte County) but not yet approved by BSL. Contractors/Owners have been notified of the unauthorized construction, and the ARC Team is waiting for applications on all three homes. Unfortunately, 18 or 36% of the 49 approved homes are experiencing delayed construction or contractor abandonment issues that have resulted in violations of the Association’s Clean Site Program. The violations are being addressed on a case-by-case basis using Clean Site and Builder’s Completion Deposit Funds to pay for site cleanup. Legal counsel has been engaged to assist in two of these instances.
Forty-four new homes received Certificates of Occupancy this fiscal year (October 2024 to September 2025). Three of these occurred in September.

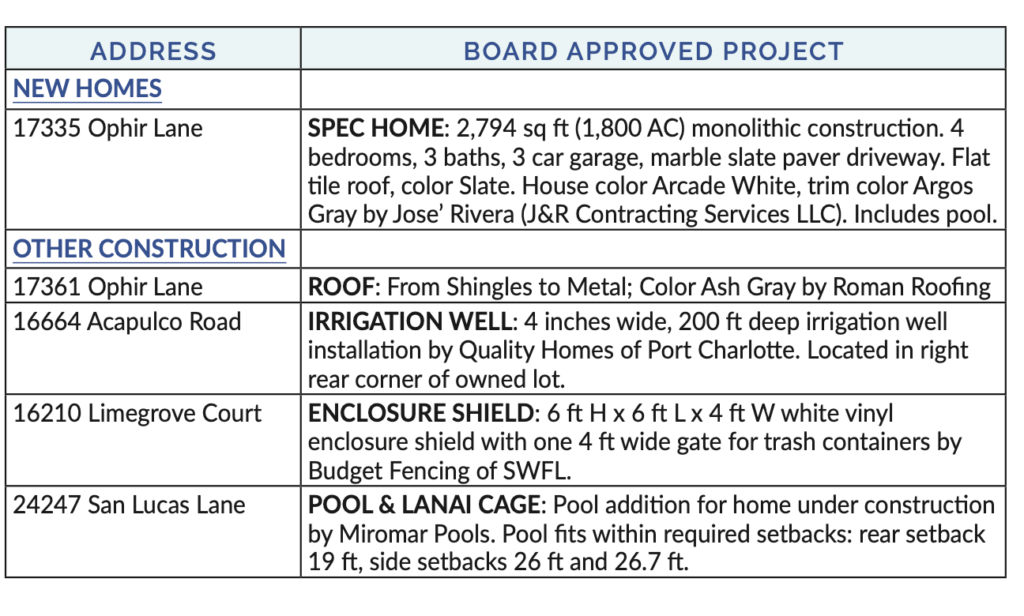

The following architectural projects were either approved or conditionally approved by the Burnt Store Lakes Board of Directors during the September 9, 2025, Board Meeting:
