Committee News

BSLPOA Architectural Review Update – October 2025

  • December 2025
  • BY BETTY INGERSON, CHAIRMAN, ARCHITECTURAL REVIEW COMMITTEE

Six Single-Family Home Applications were reviewed by ARC in October. Three were recommended for approval. One was held for additional information and two were rejected. Eleven other applications were reviewed. Seven were recommended for approval, two were rejected, and two were held for additional information.

Effective October 30, 2025, there were 52 new homes in the approved construction process. Additionally, there is one home that is authorized by Charlotte County but not yet approved by BSL. Construction has been stopped, and the ARC is waiting for an application for this home. Eighteen of the approved homes are experiencing delayed construction or contractor abandonment issues that have resulted in violations of the Association’s Clean Site Program. The violations are being addressed on a case-by-case basis using Clean Site and Builder’s Completion Deposit Funds to pay for site cleanup. Legal counsel has been engaged to assist in two of these instances.

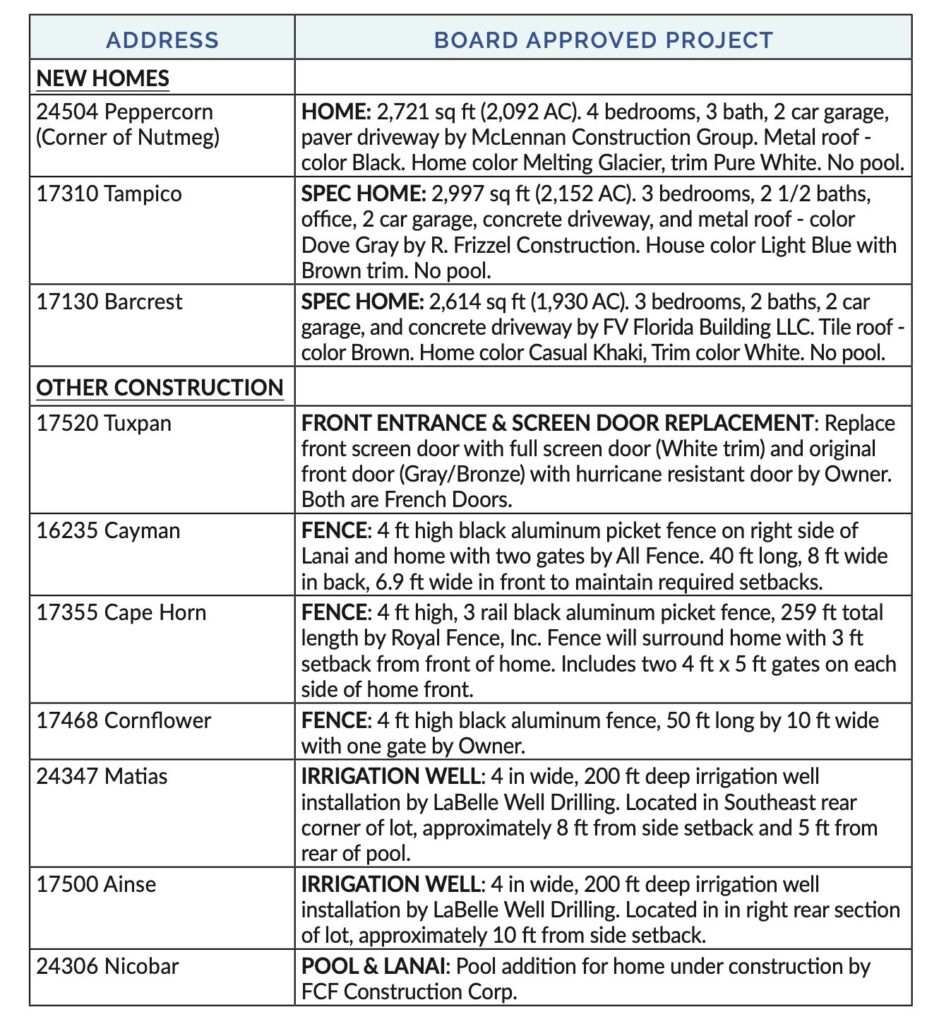

No homes received Certificates of Occupancy during October. The following architectural projects were either approved or conditionally approved by the Burnt Store Lakes Board of Directors during the October 14, 2025, Board Meeting:
